Project Description

DTE CCR Pond Closure

East China Township, Michigan

Back to Latest Projects

Project Details

DATE OF COMPLETION

September 2018 (55 working days)

CLIENT

DTE Energy

PRIME CONTRACTOR & ENGINEER
Raymond Excavating, Inc.

PROJECT TYPE

ISS

PROJECT DESCRIPTION

Stabilize 73,075 cubic yards of CCR Sludge with Portland cement.

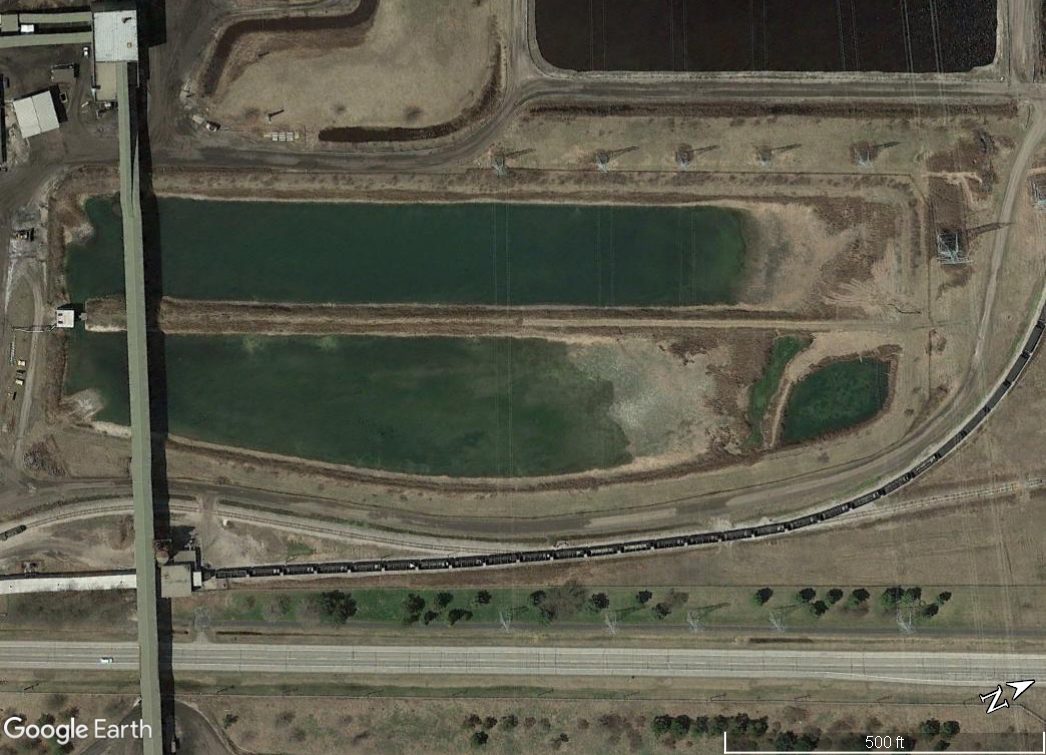

The project involved stabilizing CCR material in two ponds. The green areas are standing water which was pumped off while the work was in progress. The CCR material was sludge that was too soft to support equipment. The original estimate was 55,000 cubic yards of CCR based on the bottom elevation shown on historic drawings. ISS began at the north ends of the ponds. The bottom elevation dropped steadily as the work progressed to the south. LTC established the top and bottom elevations of the mixing cells by fabricating a probe to fit a telehandler and equipping it with GPS.

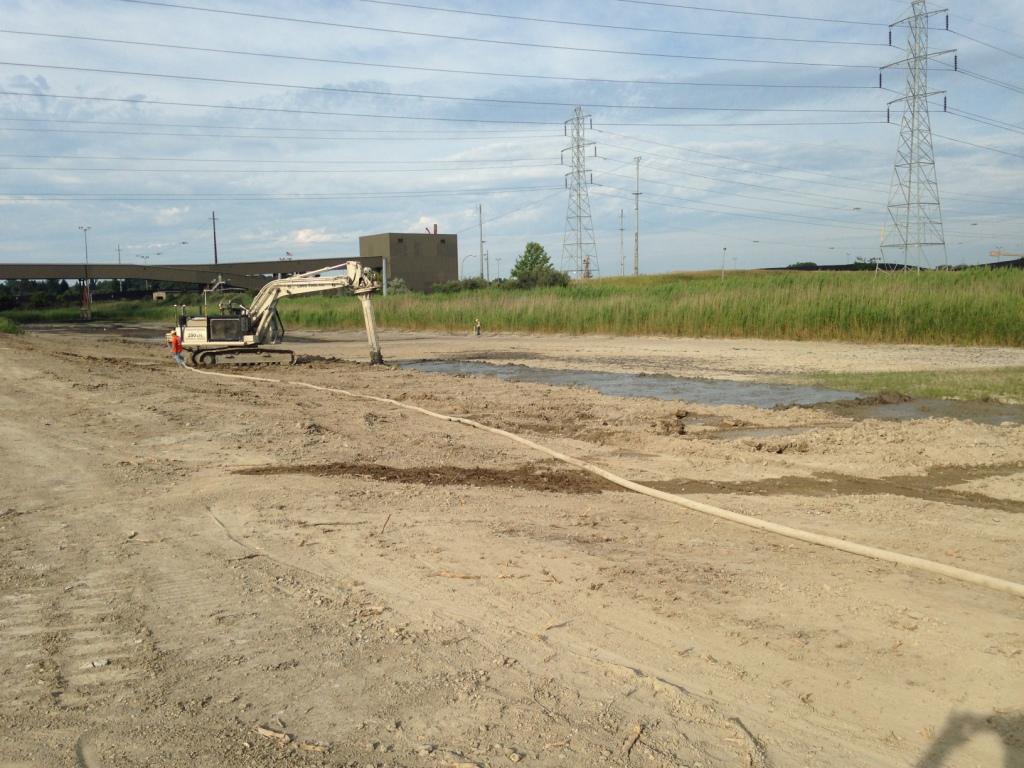

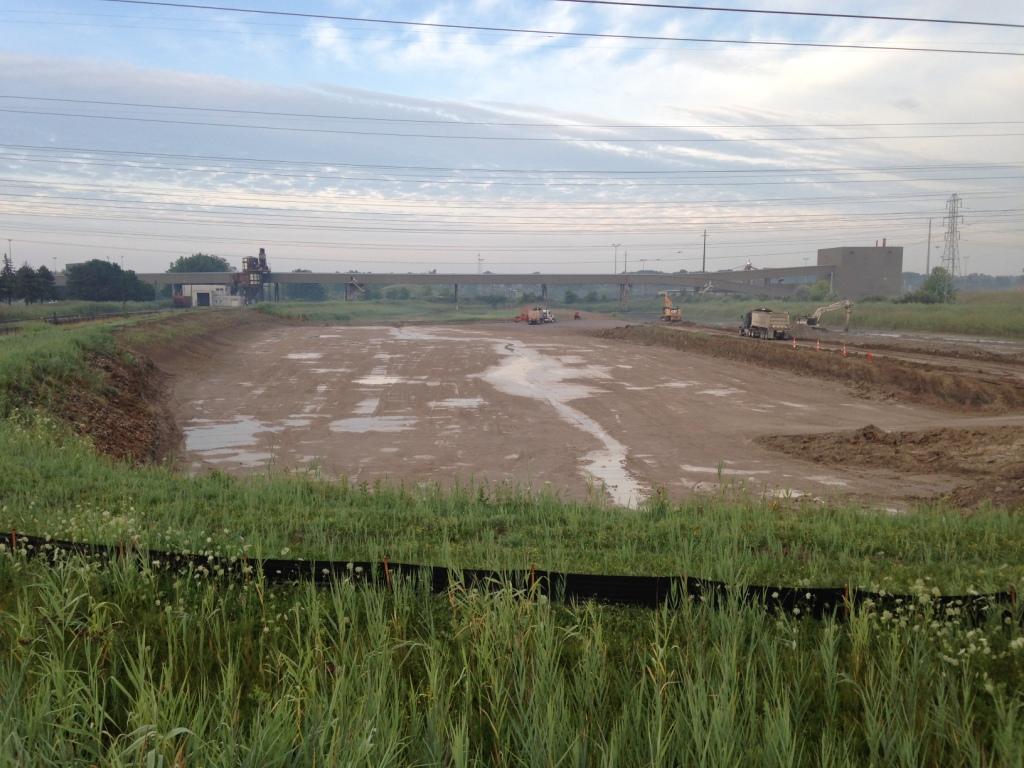

The photo (bottom left) was taken standing on the north end of the eastern pond looking south. The northern half of the eastern pond is stabilized and ISS is being performed on the western pond.



Contact Us

  • This field is for validation purposes and should be left unchanged.
